8 March 2012
Update
Real Estate
ICAI’s guidance on accounting to bring uniformity in
practice; Developers likely to shift to new norms from
April 1, 2012; Near-term impact positive for HDIL,
Prestige; Negative for DLF
ICAI’s latest guidance note
:
The Institute of Chartered Accountants of India (ICAI) has issued a guidance note
on accounting for real estate companies. The guidance applies to revenue
recognition for projects which would commence on or after April 1, 2012. The
guidance also applies to projects that are already underway, but where revenue
recognition would start on or after April 1, 2012. Although the guidance is
recommendatory in nature, we believe most real estate companies will adopt it
as it would be the default accounting norms for most auditing firms.
Key highlights of the guidance note
Commencement of revenue from projects is eligible only when all critical
approvals are in place. These include environment clearance, plans/designs,
change in land usage, title of land, etc.
Pre-requisites are (1) 25% of project is sold with secure agreement, (2) at
least 10% of amount is collected on sold portion along with no outstanding
customer default, and (3) at least 25% of construction cost has been incurred
(excluding land cost or borrowing cost).
Any loans and advances given to contractors in excess of actual work done
would be excluded for the period and would only be counted once actual
work is done.
Recognition of revenue at any point of time should not exceed the estimated
total sales revenue already under contract/agreements.
Any expected loss due to cost overruns should be booked as an expense
immediately irrespective of the stage of completion of the project.
TDR revenue is booked when the title of development right is transferred to
the buyer and the buyer of TDR would add acquisition cost of TDR to the
actual project cost.
Current accounting practices
Barring a few real estate companies like HDIL and Sunteck Realty that follow
the Project Completion Method (PCM) of accounting to recognize revenue,
most follow the Percentage of Completion Method (POCM). Under POCM,
the developers recognize revenue based on:
Pre-decided threshold level (a certain percentage of estimated
construction cost); before crossing the threshold level, all collections
from customers and cost incurred are treated as “Advances” and “WIP”.
Post-threshold revenue is booked based on actual progress in execution.

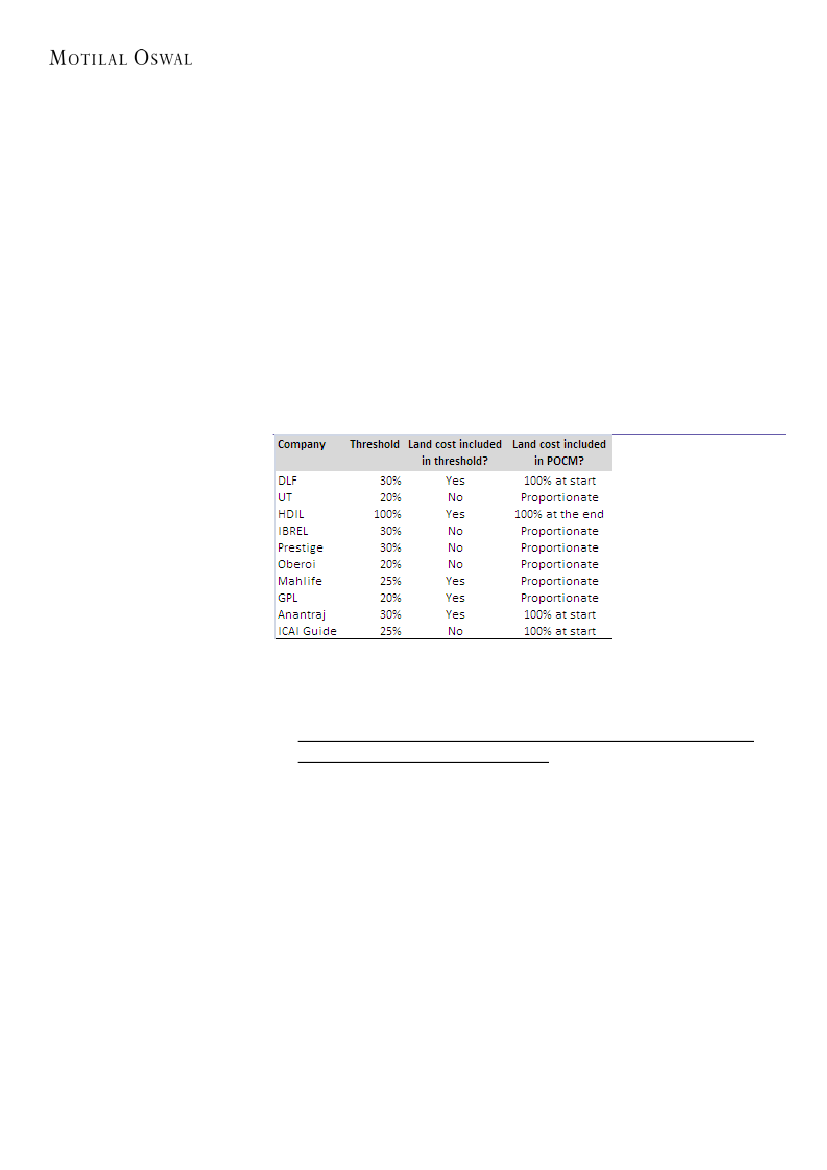

However, the developers are divided in exact application of POCM. There is
1
